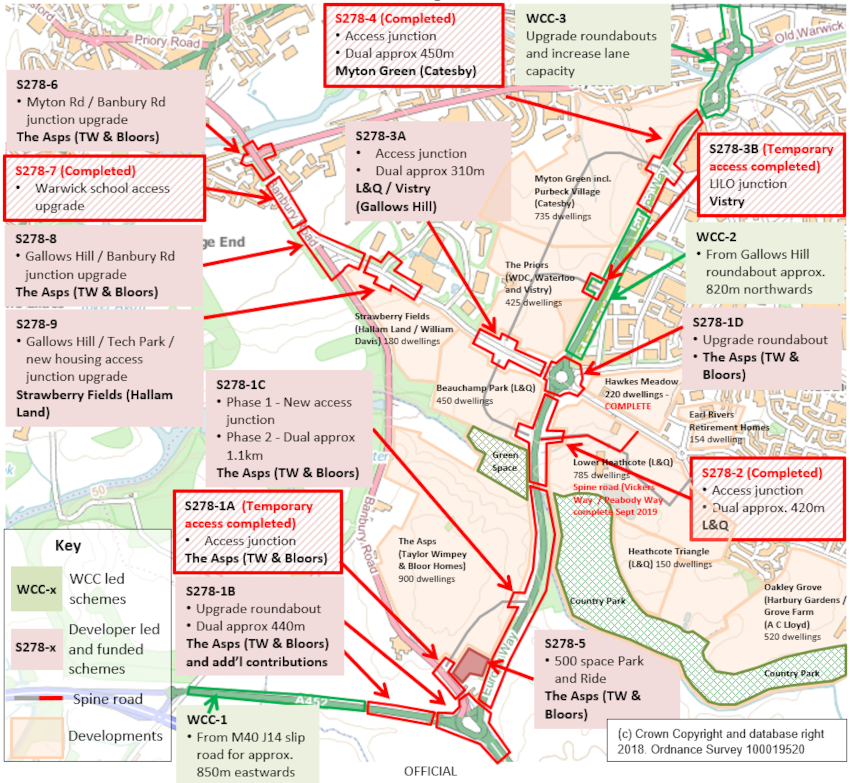

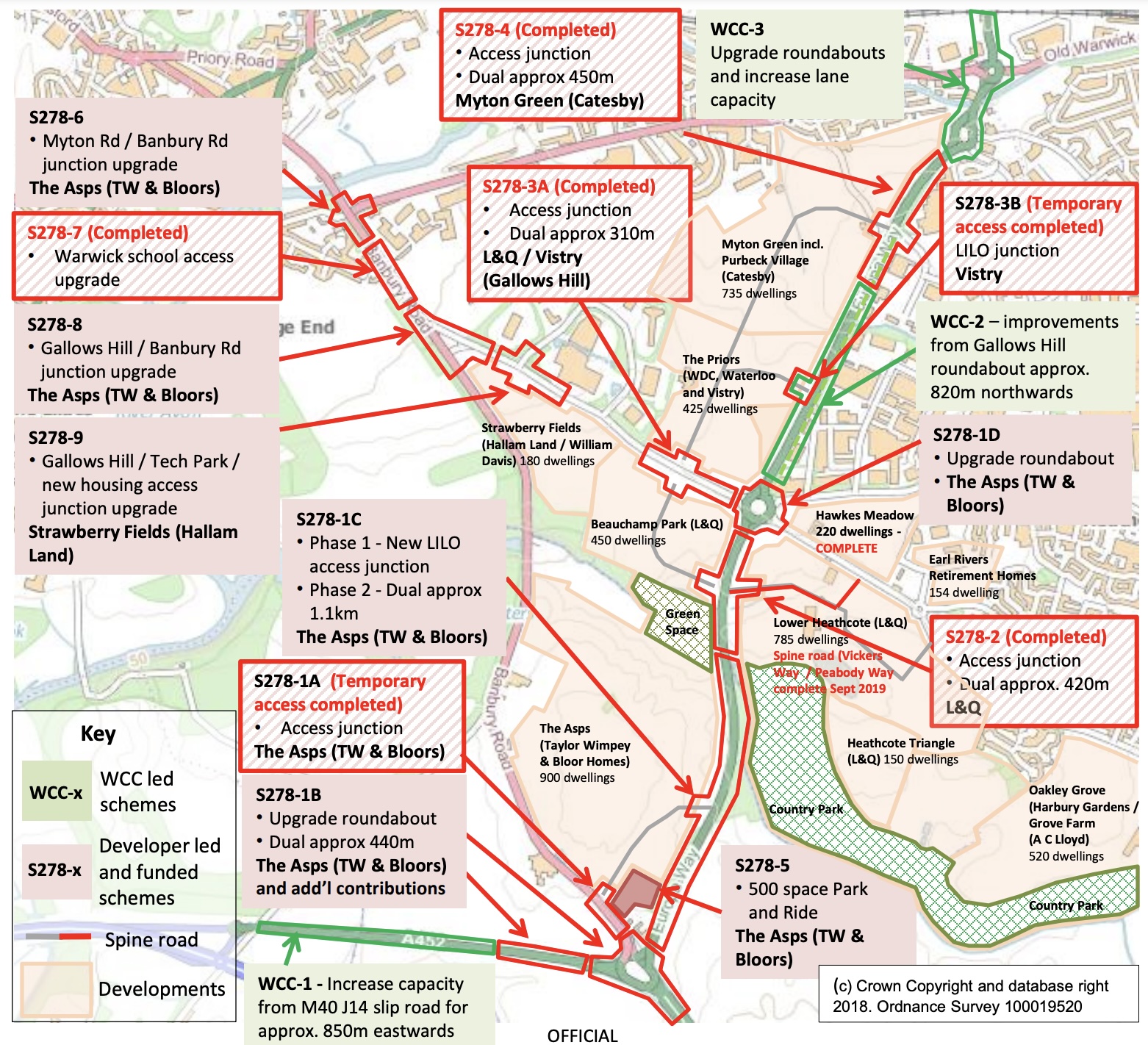

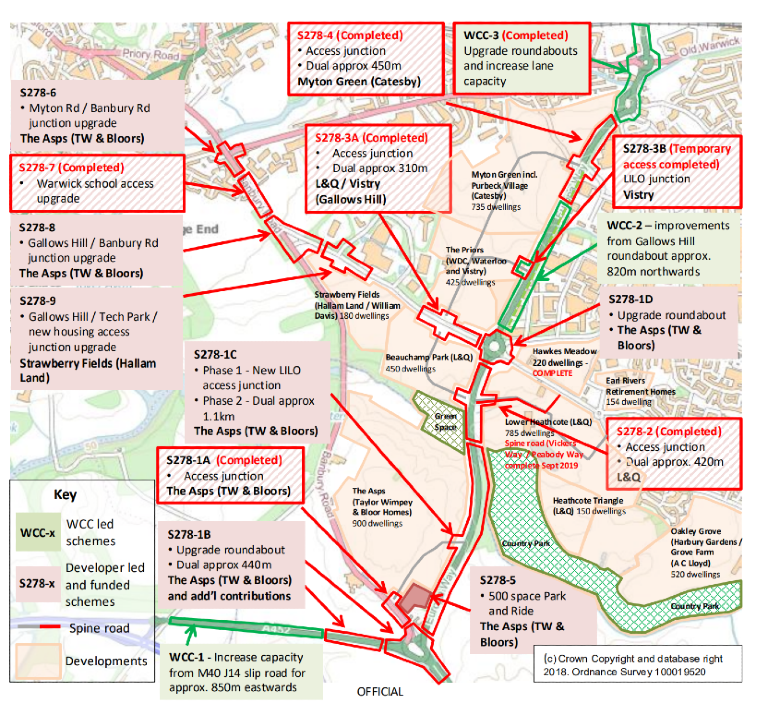

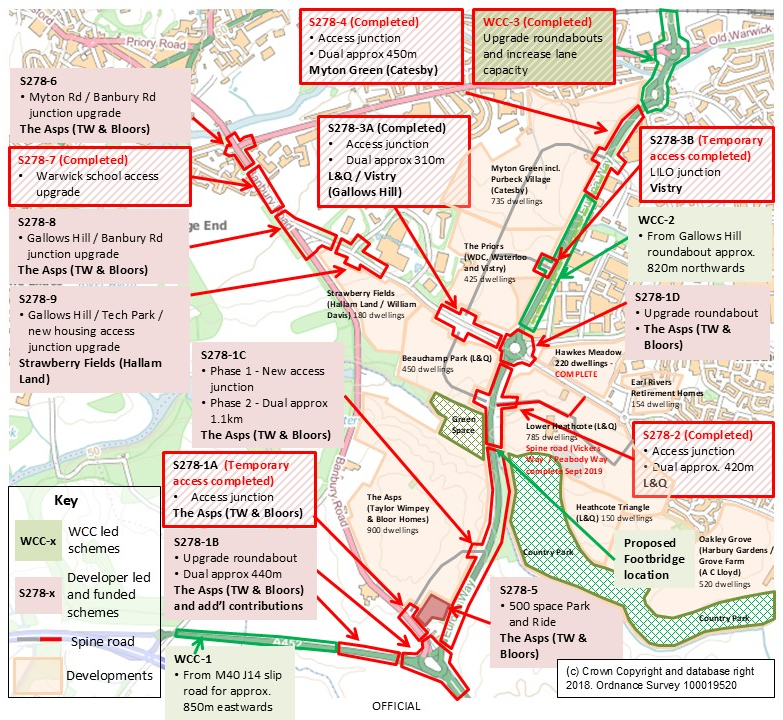

Construction schemes
Scheme reference |
Location |
Scheme description |
Scheme status |
---|---|---|---|
WCC-1 |
A452 from M40 J14 slip road for approx. 850m eastwards |
Capacity and safety improvements |
Feasibility |
WCC-2 |
A452 Europa Way from Gallows Hill roundabout approx. 820m northwards |
Active travel and capacity improvements |
Optioneering |
WCC-3 |
Ford Foundry roundabout and Queensway roundabout |
Upgrade roundabouts and increase lane capacity |
Construction due to start in May 2024 for 12 months |
S278-1A |
The Asps - access off Banbury Road |
Access junction |
Minor access constructed in May 2022 |
S278-1B |
Greys Mallory Roundabout and Banbury Spur dualling |
Upgrade roundabout and dual approximately 440m |
Design |
S278-1C |
Access junction off Europa Way and dualling A452 from Greys Mallory roundabout northwards |
Dual approximately 1.1km and new access junction |
Design |
S278-1D | Europa Way/Gallows Hill/ Harbury Lane roundabout | Upgrade roundabout | Design |
S278-2 |
Europa Way, Beauchamp Park and Lower Heathcote |
Dual approximately 420m and access junction |
Completed in August 2019 |
S278-3A |
Gallows Hill - access junction to Beauchamp Park and The Priors |
Dual approximately 310m and access junction |
Completed in April 2024 |
S278-4 |
Europa Way and Myton Green |
Dual approximately 450m and access junction |
Completed in November 2021 |
S278-5 |
Europa Way and Banbury Road |
500-space Park and Ride |
Design |
S278-6 |
Bridge End roundabout |
Myton Road and Banbury Road junction upgrade |
|
S278-7 |
Banbury Road and Warwick School |
Warwick School access upgrade |
Completed in October 2019 |
S278-8 |
Gallows Hill and Banbury Road |
Gallows Hill and Banbury Road junction upgrade |
|
S278-9 |
Gallows Hill and Warwick Technology Park junction |
Gallows Hill, Warwick Technology Park, and Strawberry Fields housing estate access junction upgrade |
Design |
