Proposed works
These works form part of the Historic Bridge Maintenance Programme.
The works are expected to include:

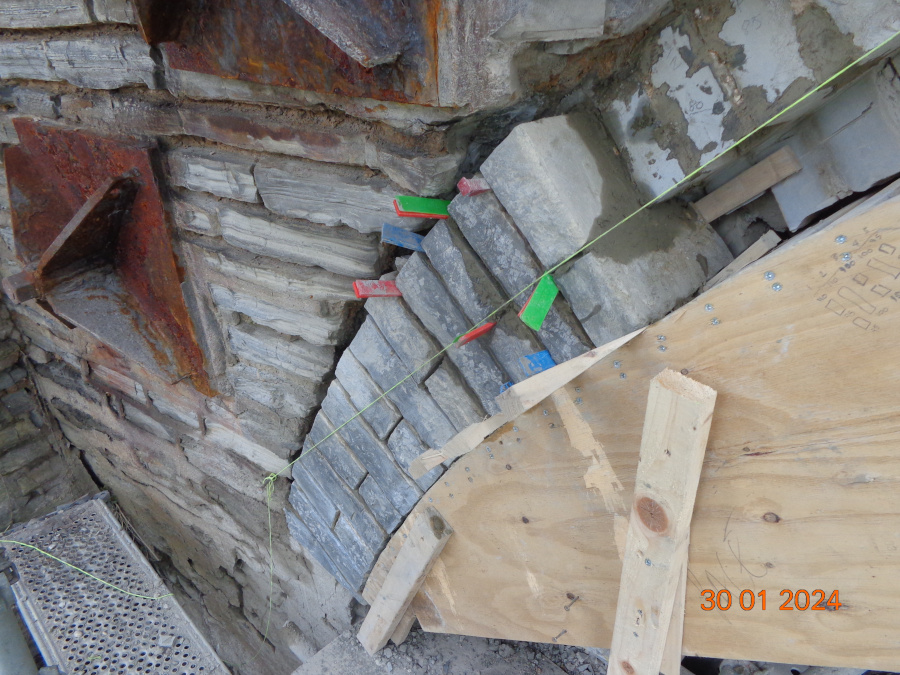

- Extensive repair of missing and damaged stonework including masonry replacement and refacing (above and below water level), repointing, scour repairs and carriageway resurfacing.

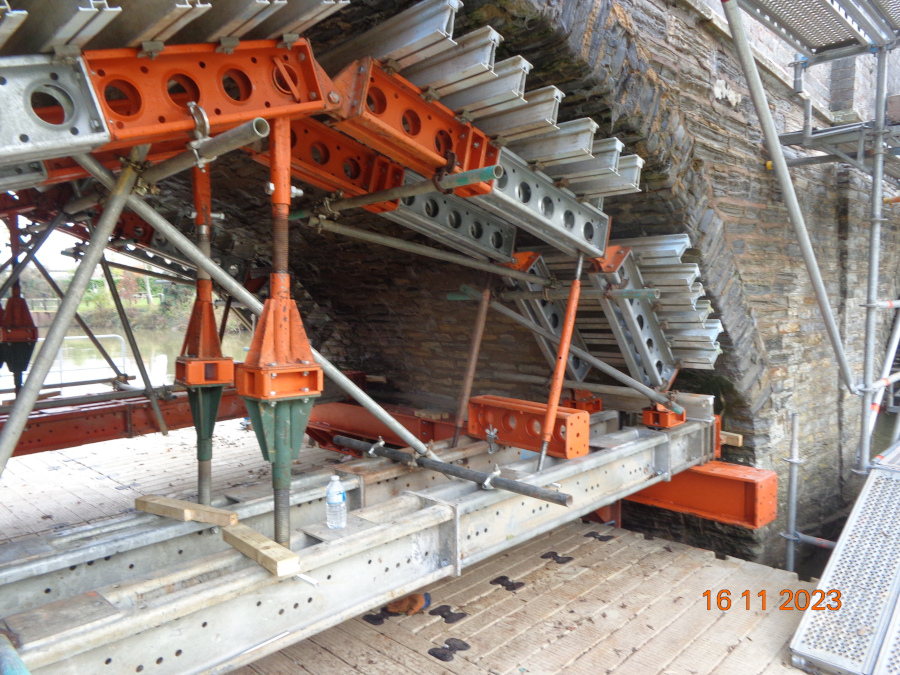

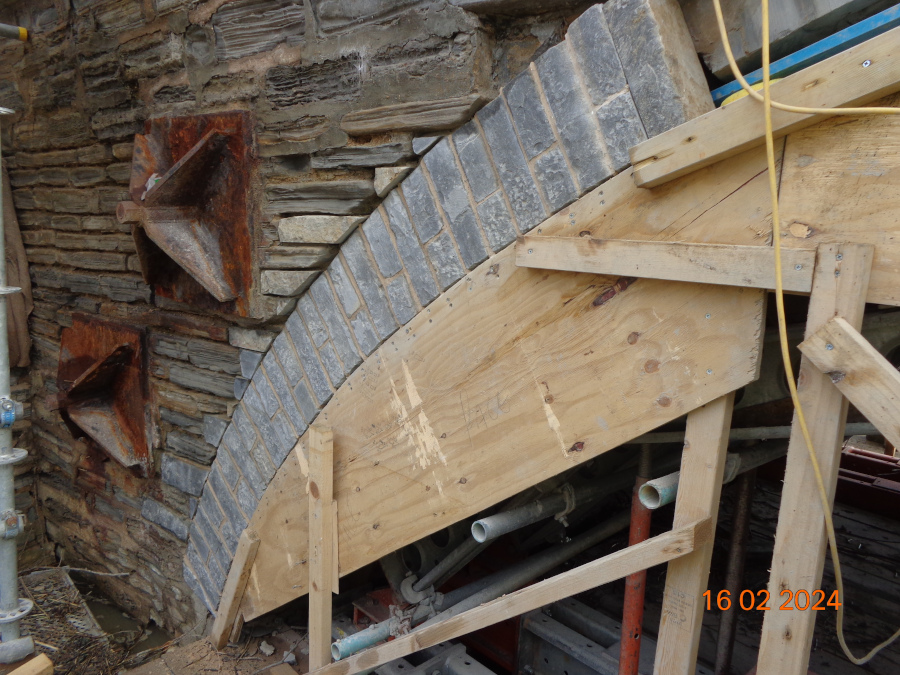

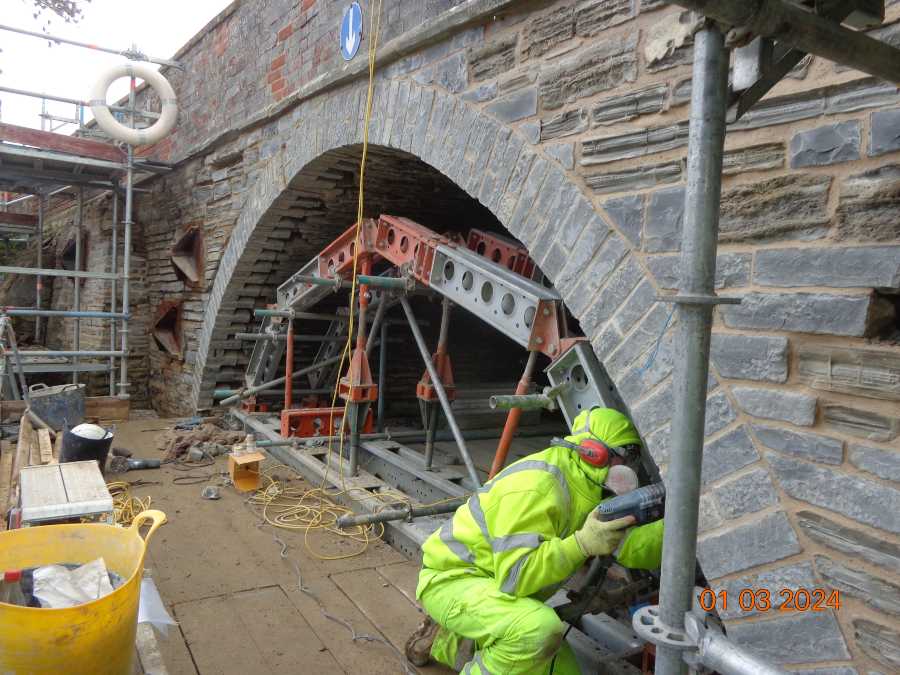

- Arch strengthening and repairs to the tie-bars.

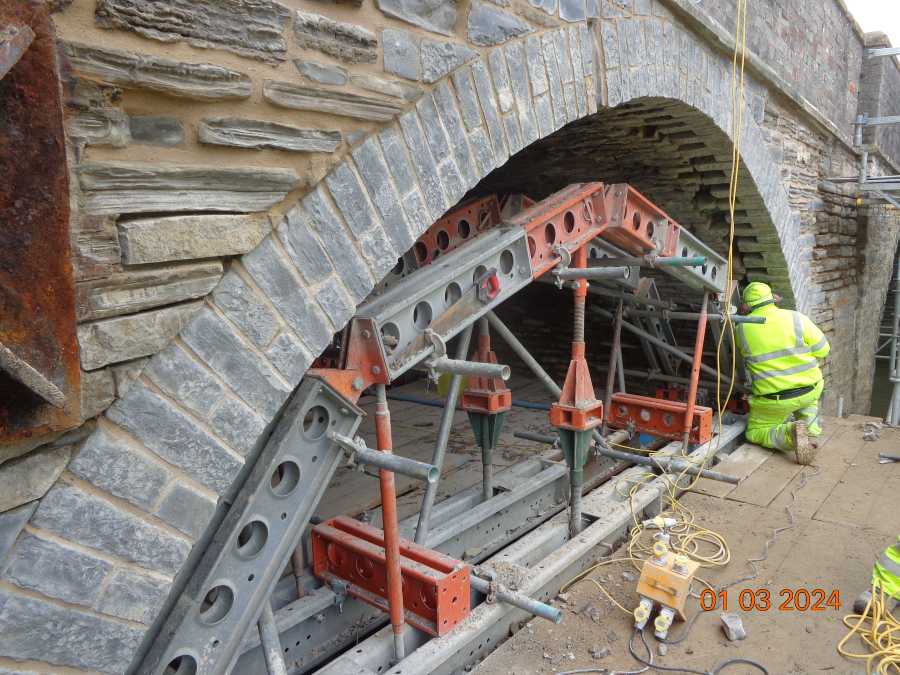

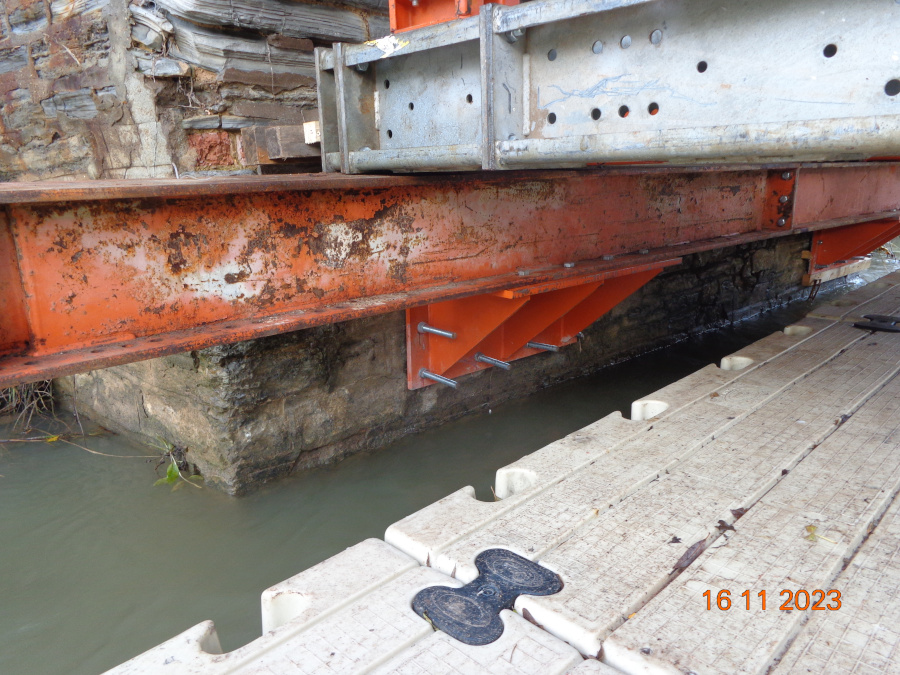

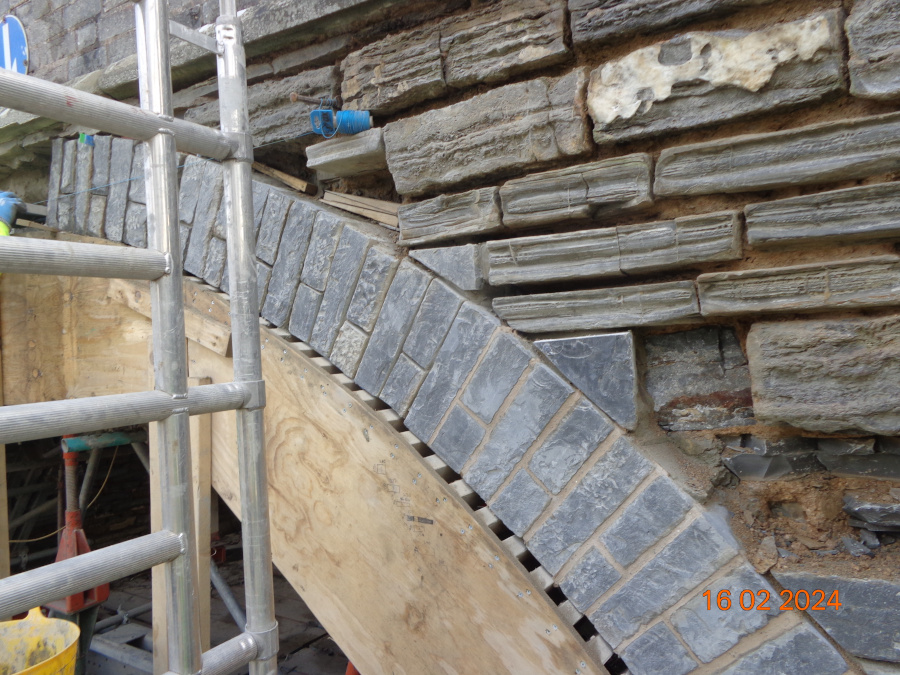

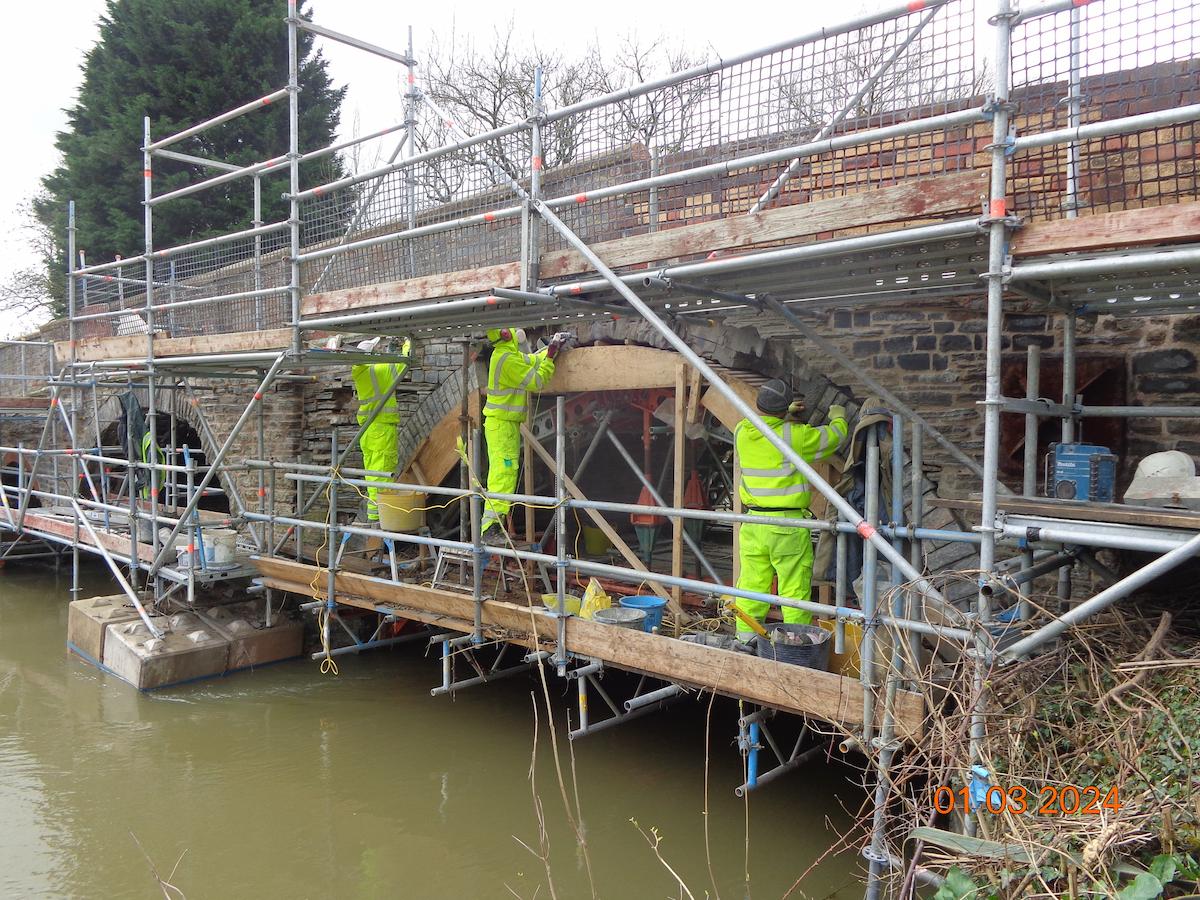

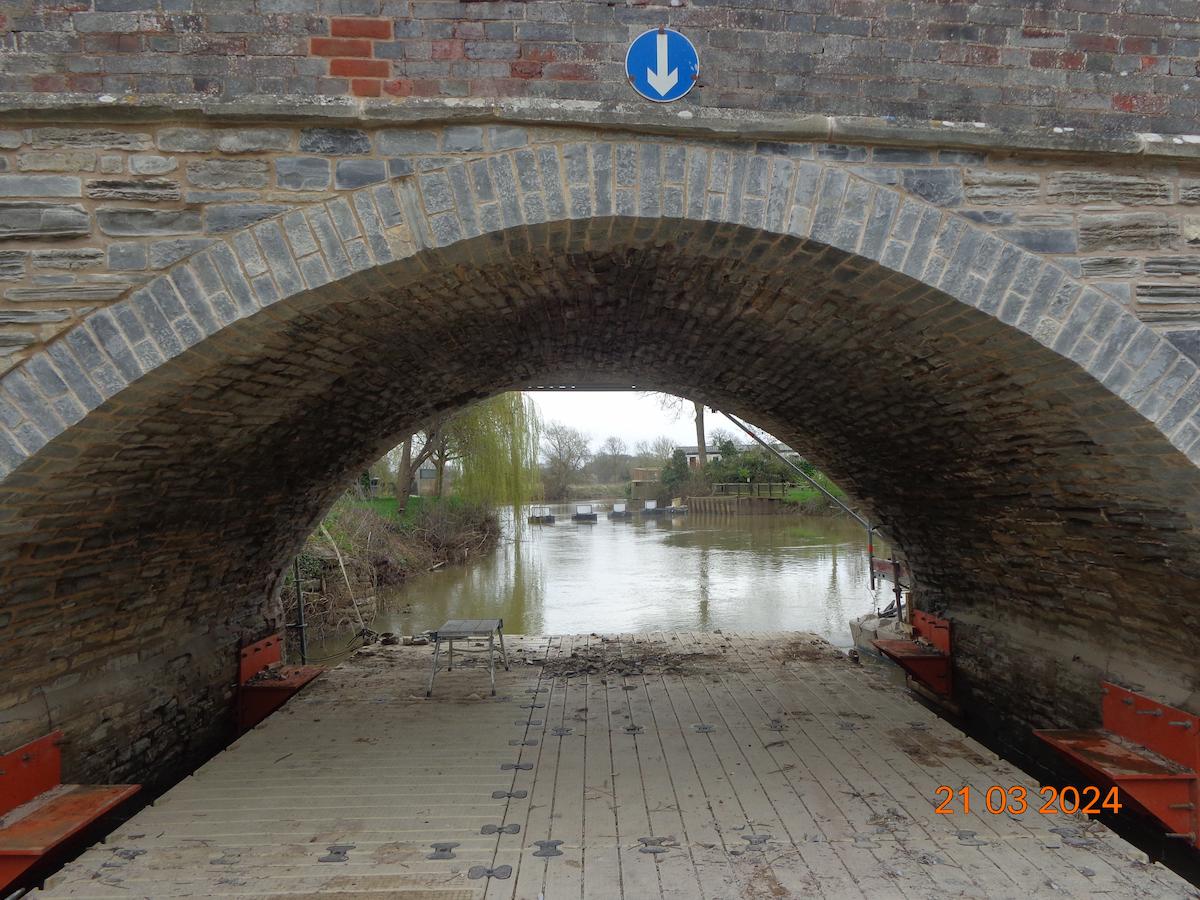

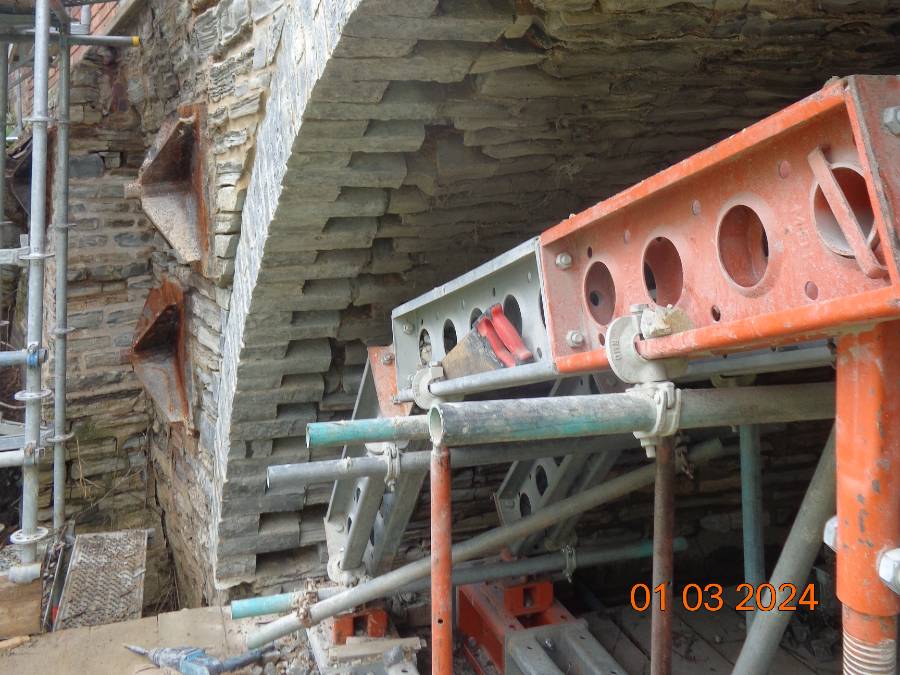

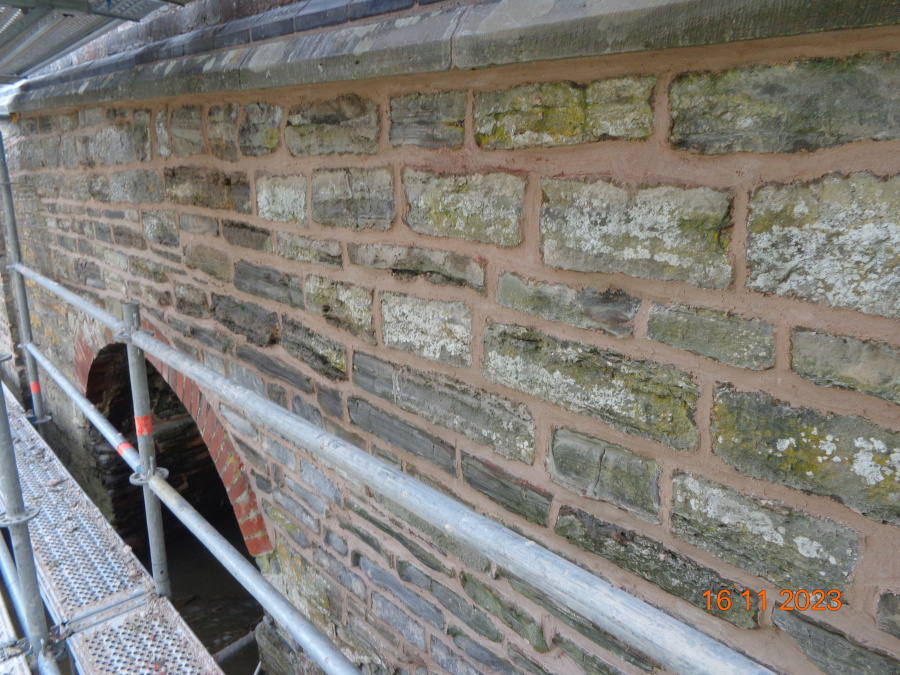

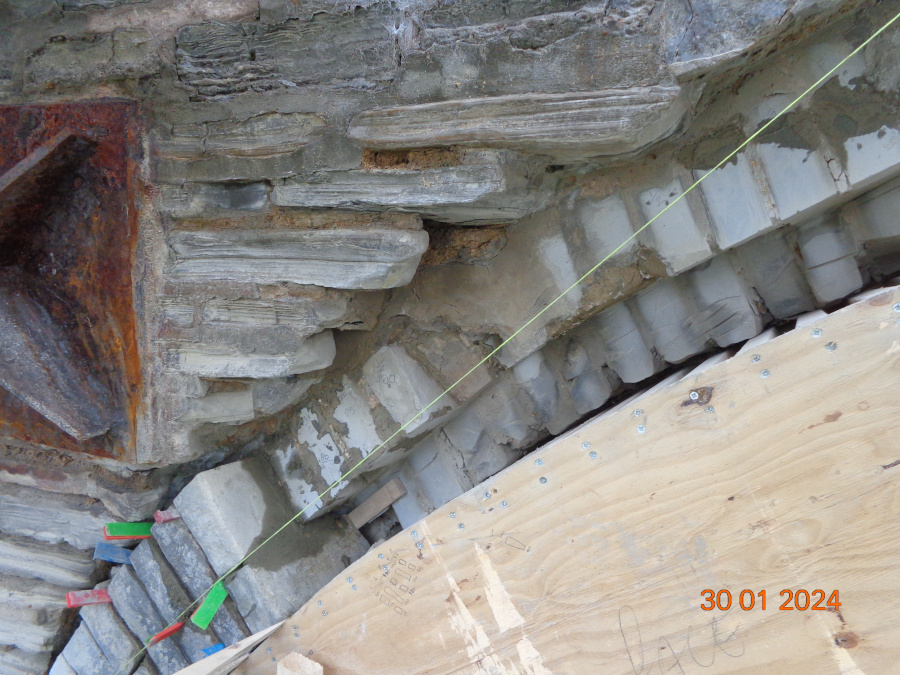

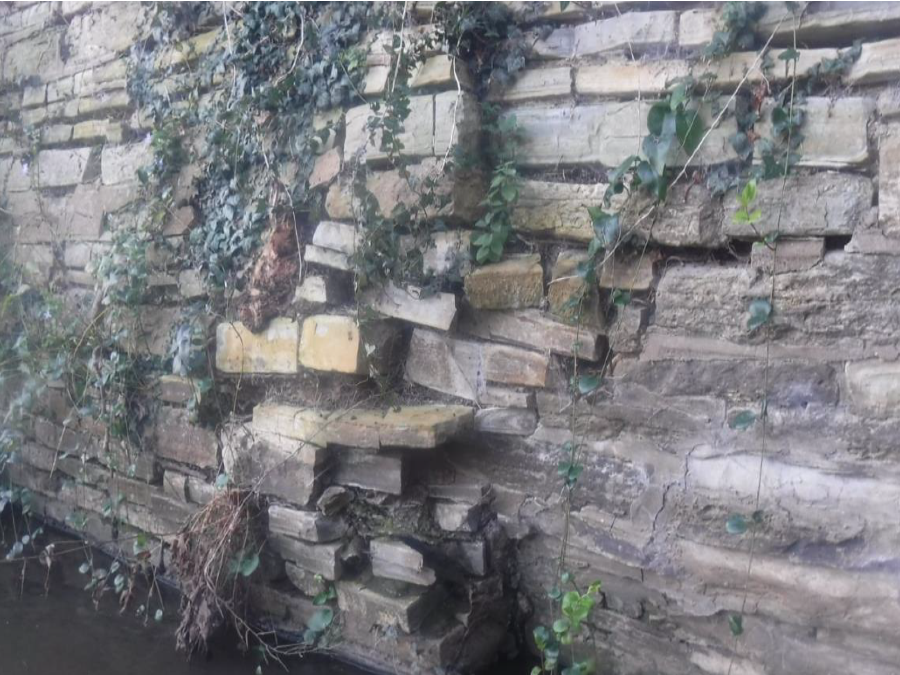

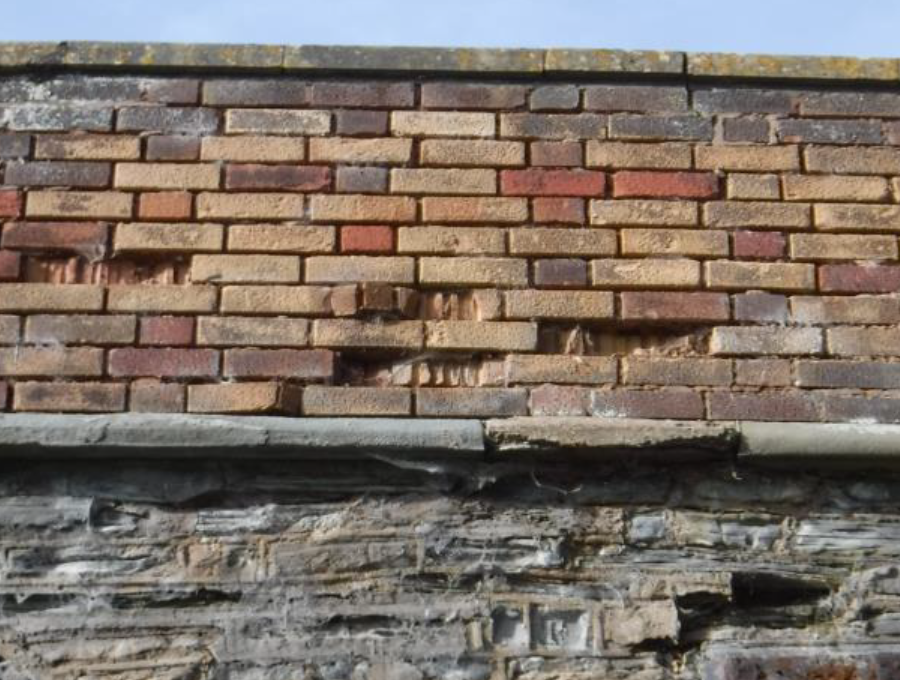

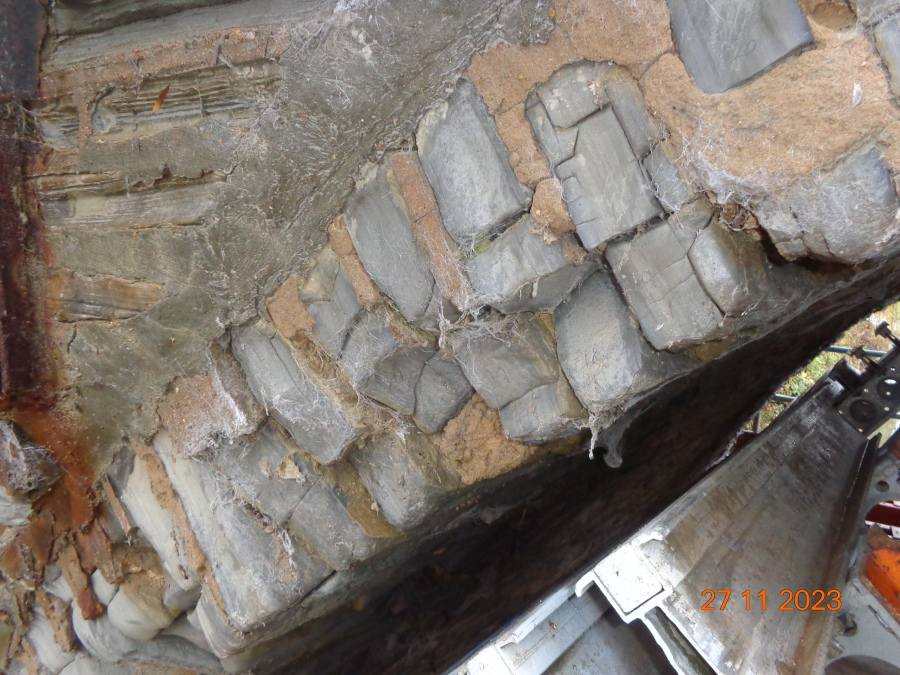

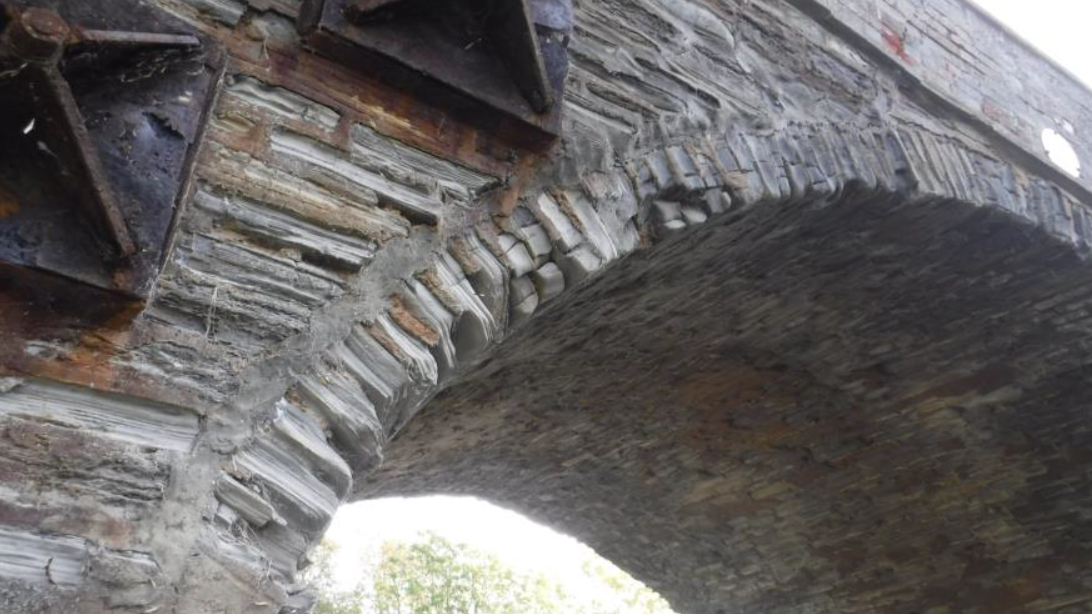

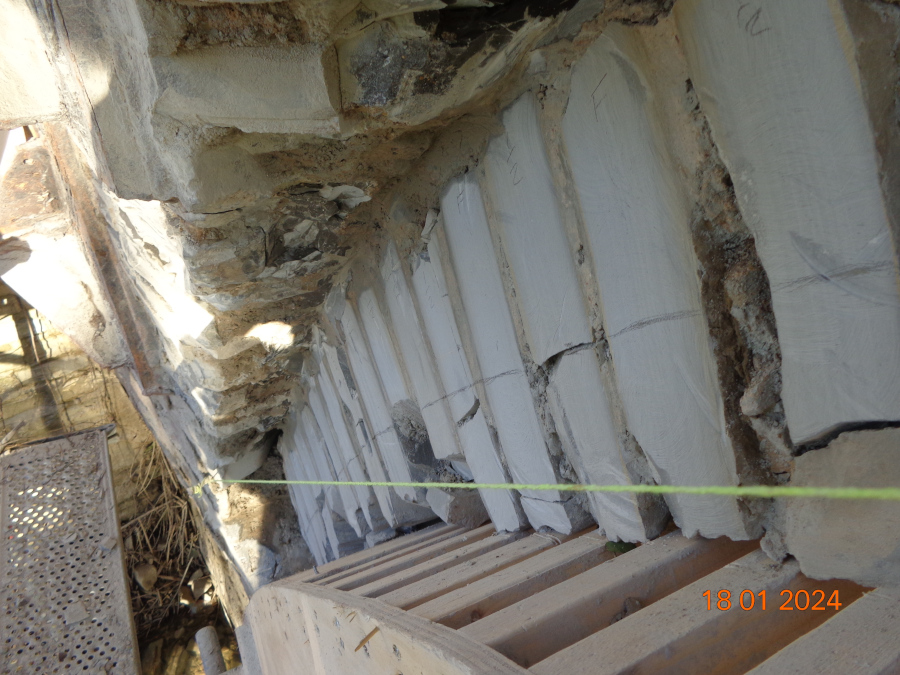

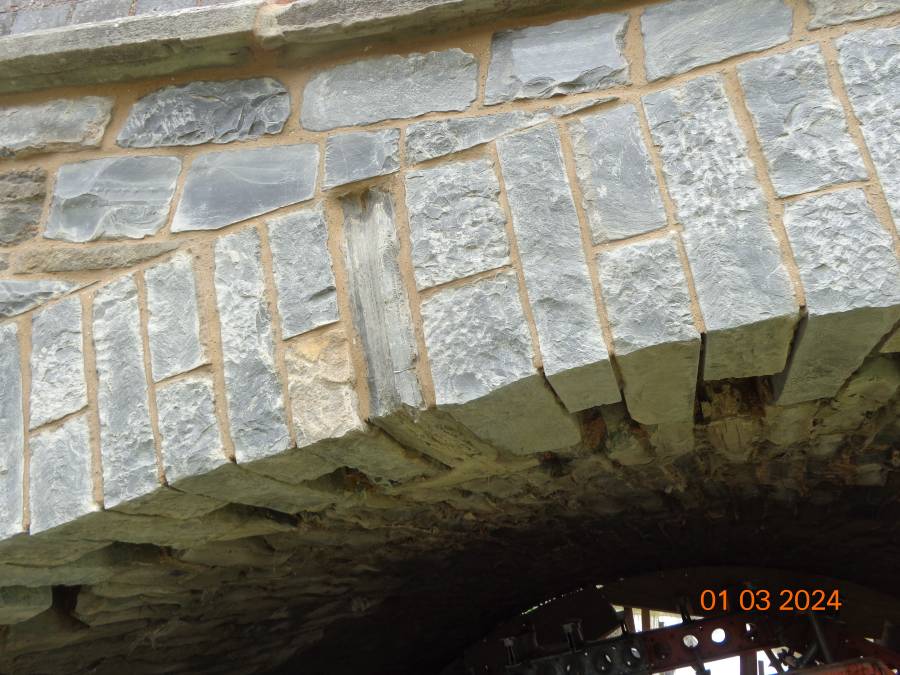

Missing and damaged stonework

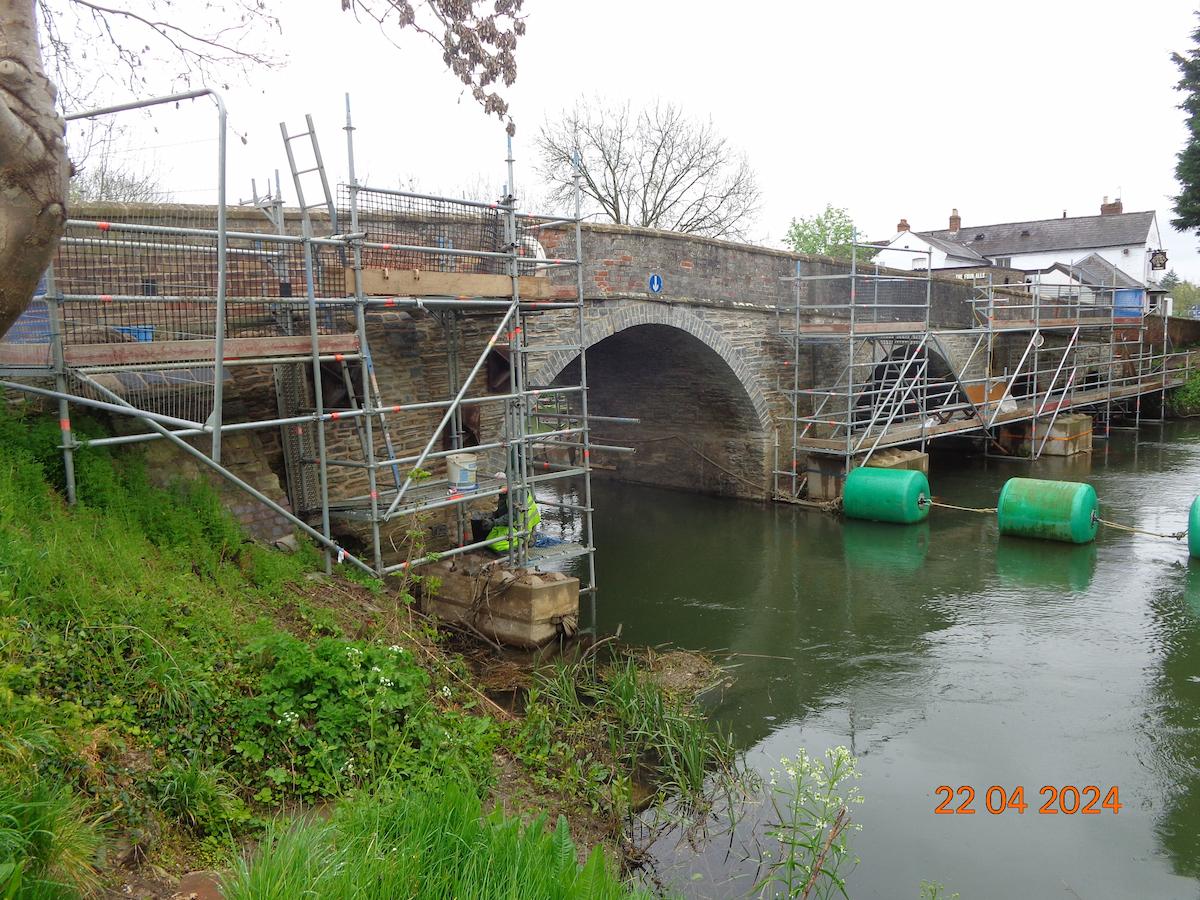

These works will maintain the highway structure function for both pedestrians and vehicular traffic which in turn will increase the service life of the structure and reduce future maintenance costs.

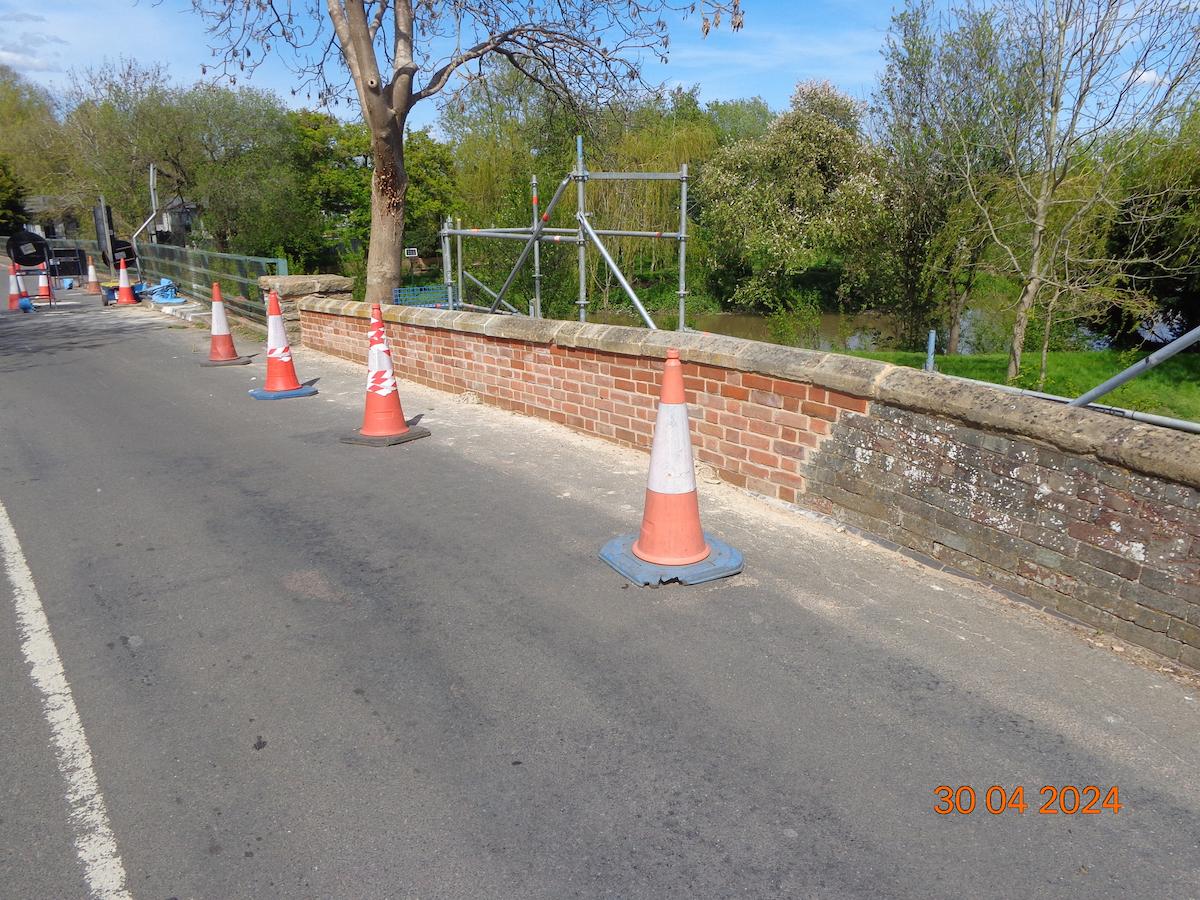

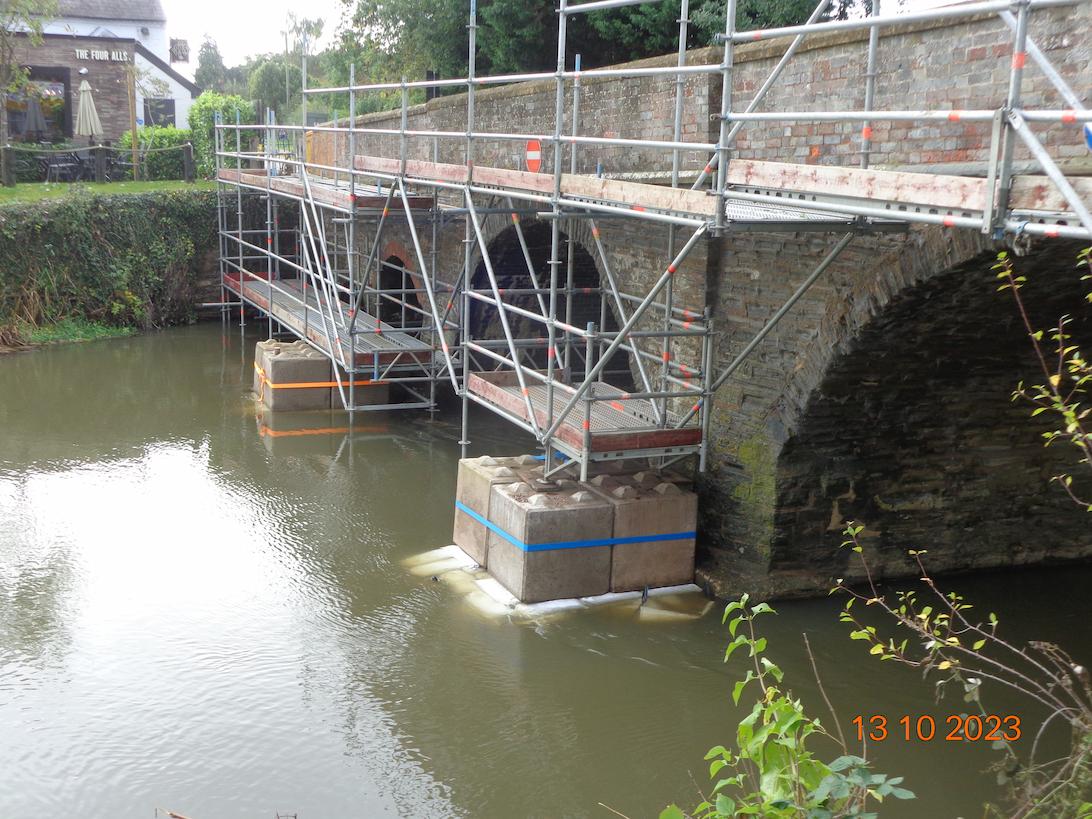

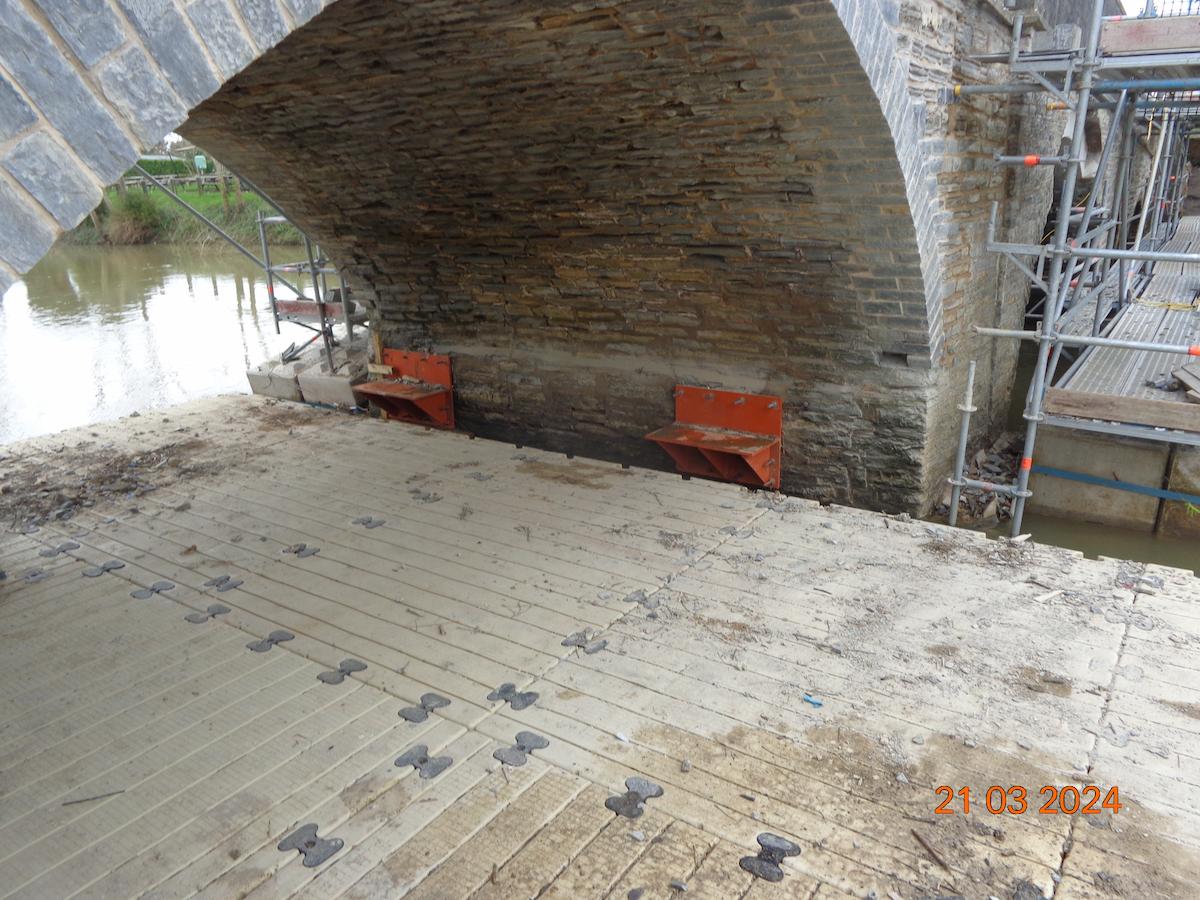

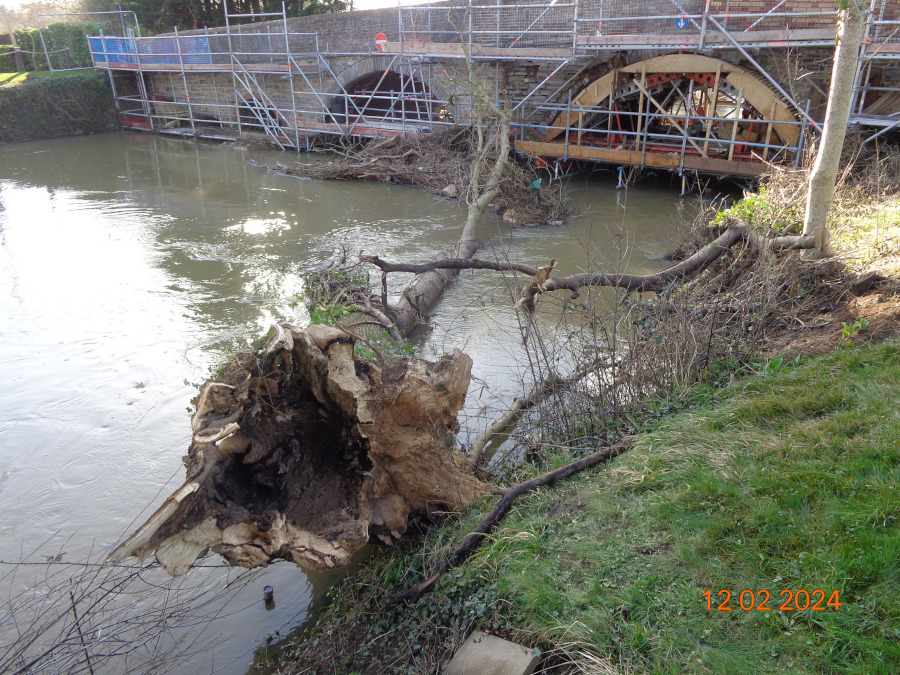

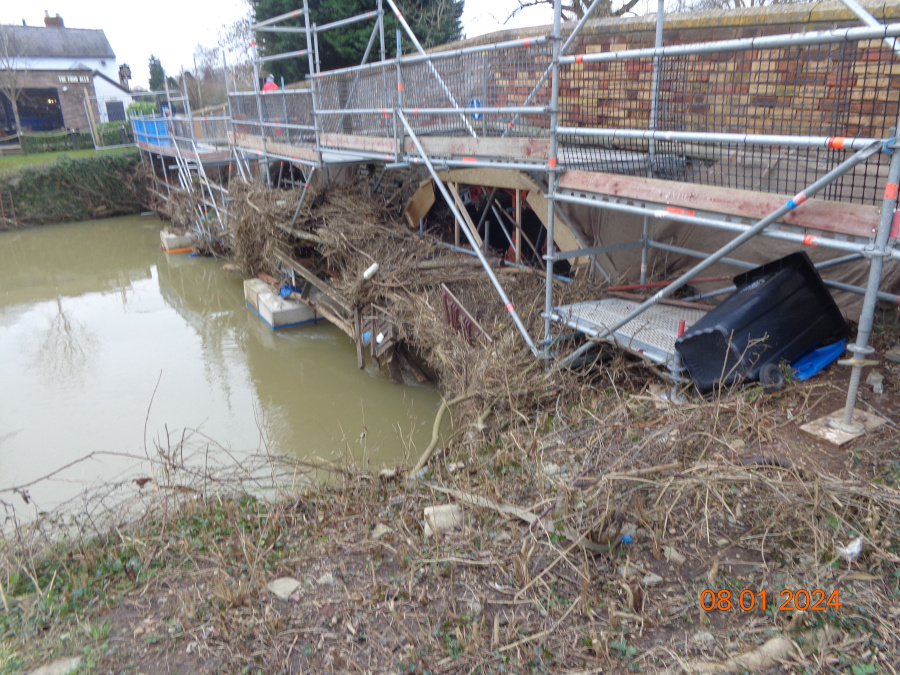

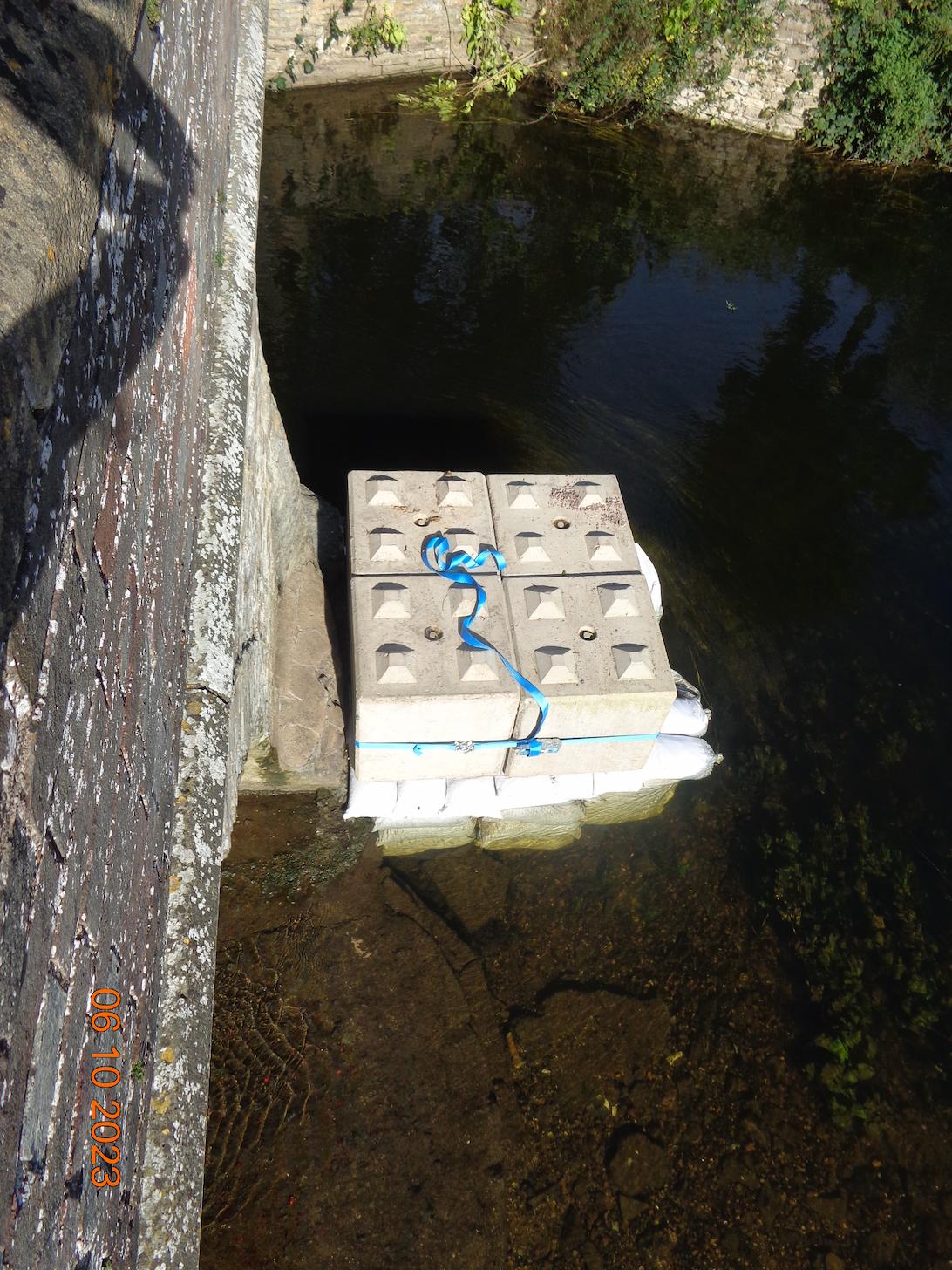

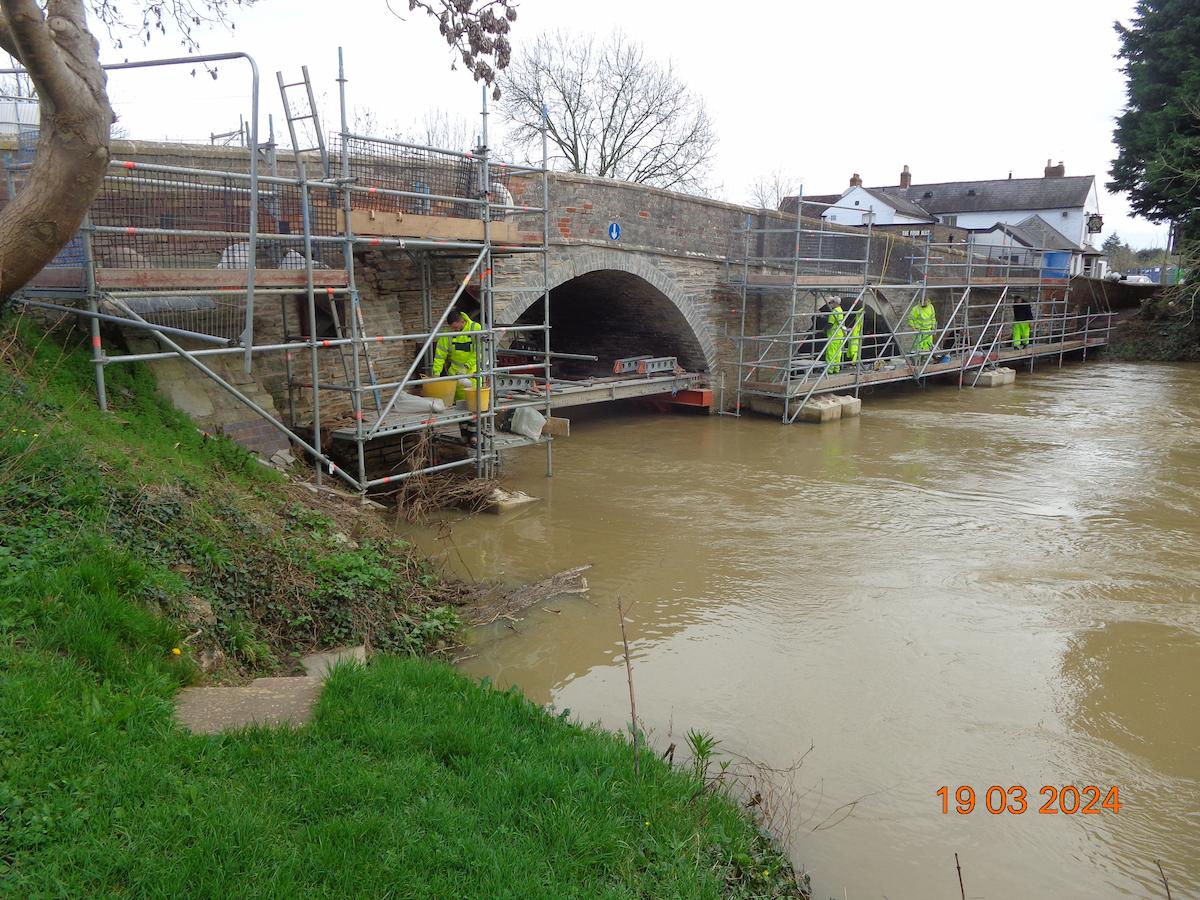

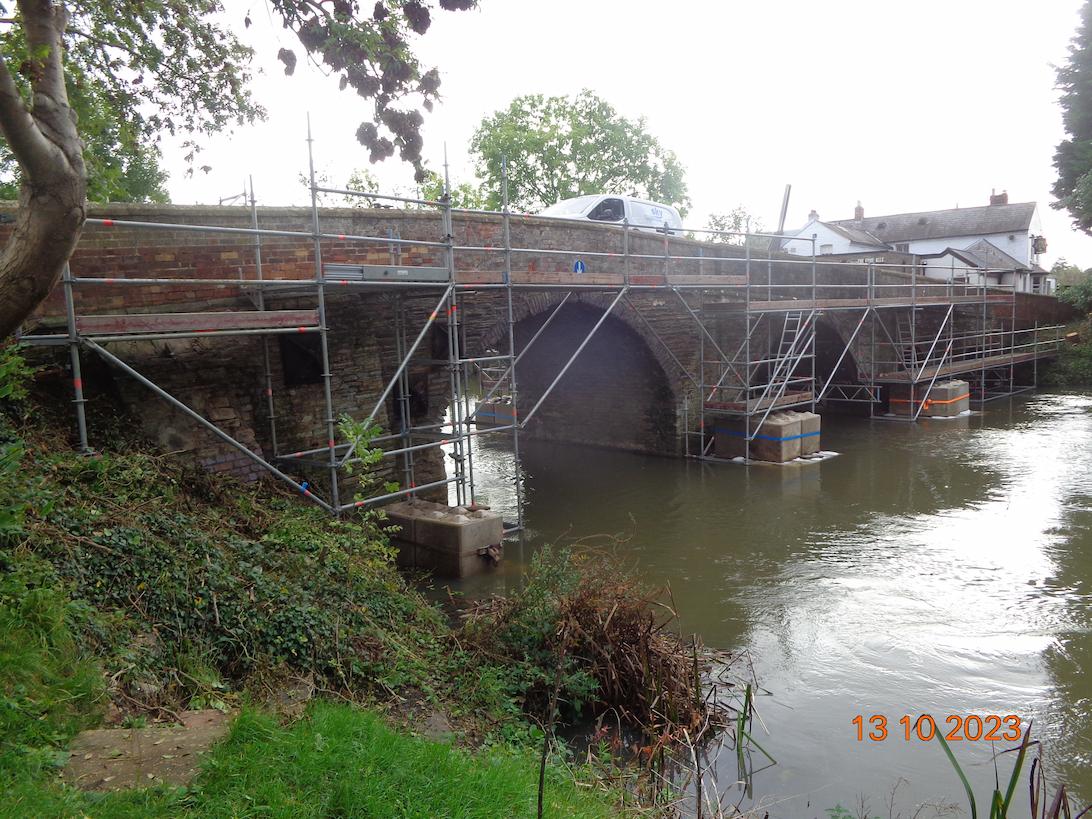

Site works have commenced on Monday 2 October 2023 and are due to be completed 7 June 2024.
Traffic management type | Duration | Date start | Date end |
---|---|---|---|
2-way temporary lights (cleared for marathon 21/4/24) | 58 days |
Sat 23/3/24 |
Sun 19/5/24 |
Road closure (with pedestrian access) | 4 days | Mon 20/5/24 | Thur 23/5/24 |
Road closure (no pedestrian access) | 1 day |
Fri 24/5/24 |
Fri 24/5/24 |
2-way temporary lights | 14 days |
Sat 25/5/24 |
Fri 7/6/24 |
Fully open | 0 days | Fri 7/6/24 | Fri 7/6/24 |
Please note these times and durations are subject to review as the works are progressed.
